Most people think building a custom home starts when the excavator arrives on site. In reality, the work that happens before the first shovel goes into the ground is what determines whether your project finishes on time, on budget, and to the standard you expect.
The pre-construction phase of a custom home build typically takes 3 to 6 months, sometimes longer, depending on the complexity of the design and the City’s permitting timeline. Understanding what happens during this period helps you make better decisions, avoid costly delays, and arrive at construction day genuinely prepared.

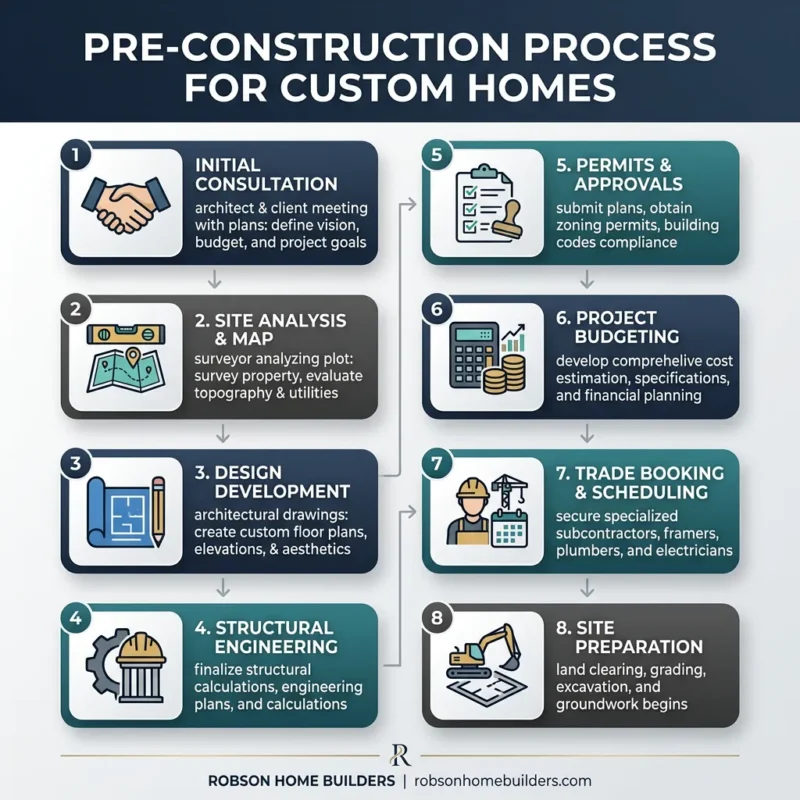

Here’s the complete step-by-step breakdown.
Step 1: Initial Consultation and Vision Setting
Every custom home project begins with a conversation. Before any design work or site assessment happens, your builder needs to understand what you’re trying to achieve.
This includes:
- How you live, do you work from home, do you have young children, do you host frequently?
- What you need: number of bedrooms and bathrooms, garage size, basement, and outdoor space
- What you want, architectural style, finishes, special features
- Your budget, a realistic total project budget, not just the construction cost
- Your timeline, when you need to be in the home
A good builder will push back constructively during this conversation, not to discourage you, but to make sure what you’re describing is achievable within your budget and timeline. This honesty up front saves everyone time and frustration later.
At Robson Home Builders, Nick Robson personally leads the initial consultation. He brings 20+ years of Abbotsford and Fraser Valley experience to that first meeting, which means the advice you get is specific, practical, and grounded in local reality.
Step 2: Lot Assessment and Site Analysis
If you already own a lot, your builder will visit the site to assess the conditions that affect how, and how much, it costs to build there. If you’re still searching for land, a good builder can help you evaluate lots before you commit.
A site assessment covers:
- Lot orientation, sun exposure, prevailing winds, and how the home can be positioned for best natural light
- Topography, flat vs sloped lots, affects foundation requirements and cost significantly
- Soil conditions, some Abbotsford lots, particularly in areas with clay or fill, require engineered foundation systems
- Drainage, how water moves across and away from the site, affects basement design and landscaping
- Utility connections, distance to water, sewer, gas, and electrical services affect site development costs
- Zoning and setbacks, what you can build, how big, and how close to the lot lines
Abbotsford has a mix of lot conditions across different neighbourhoods. Eagle Mountain lots, for example, often require more complex site engineering due to slope, something an experienced local builder will flag early so it’s in your budget from the start.
Step 3: Design and Architectural Plans
Once the site is assessed and your vision is clear, the design phase begins. For a custom home, this typically involves working with an architect or residential designer to create plans that reflect your lifestyle, suit the lot, and comply with Abbotsford’s zoning and building requirements.
The design process usually happens in stages:
- Conceptual design, rough floor plan and massing to confirm the overall layout works
- Design development, refined floor plans, elevations, and key material selections
- Construction documents, detailed drawings required for permit submission and contractor pricing
This stage takes time, typically 6 to 12 weeks for a custom home. Rushing it almost always creates problems during construction when a detail that wasn’t worked out becomes an expensive change order.
Step 4: Engineering and Structural Review
Beyond architectural design, most custom homes require structural engineering, particularly for homes with open-plan layouts, large spans, multi-storey construction, or complex rooflines. In BC, structural engineering is also required for foundation design on any lot with challenging soil conditions.
The structural engineer works alongside the architect to make sure the design can actually be built the way it’s drawn, and that it will meet BC Building Code requirements.
Step 5: Building Permit Application
In Abbotsford, building permits for new custom homes are submitted to the City of Abbotsford’s Building Permits & Inspections department. The application package includes your architectural drawings, structural engineering, energy modelling (required under BC’s Step Code), and site plan.
Permit review timelines in Abbotsford vary. For a straightforward custom home on a residential lot, allow 6 to 12 weeks for approval. Homes in more complex zones, or with non-standard design elements, may take longer.
A builder with established relationships with the City’s building department, and who ensures the submission package is complete and compliant, minimizes back-and-forth and keeps the timeline moving.
Robson Home Builders has worked with the City of Abbotsford building department for decades. That familiarity means our permit submissions are thorough, our questions get answered quickly, and our clients don’t wait longer than necessary.
Step 6: Finalizing the Budget and Construction Contract
With architectural drawings and structural engineering complete, your builder can now price the project accurately. This is when the detailed construction budget is finalized, breaking down costs by trade so you understand exactly what you’re paying for.
Review the contract carefully before signing. Key things to understand:
- What is the payment schedule, and what triggers each payment?
- How are changes and additions handled? What is the change order process?
- What are the specifications, exactly what materials and finishes are included?
- What are the milestones, and what dates are the builder committing to?
- What warranty is provided, what does Pacific Home Warranty cover and for how long?
Step 7: Trade Booking and Pre-Construction Meetings
Before construction begins, your builder confirms the availability of all the trades involved in the project: excavation, foundation, framing, roofing, electrical, plumbing, HVAC, insulation, drywall, and finishing trades.
In the Fraser Valley’s current construction market, trade availability matters. An experienced builder with established relationships with reliable subcontractors has a significant advantage over newer builders still building their network.
A pre-construction meeting with you, the builder, and key trades confirms everyone understands the project, the timeline, and the specifications before ground is broken.
Step 8: Site Preparation
With permits approved, budget confirmed, and trades booked, site preparation begins. This includes marking the building footprint, setting up site hoarding or fencing, arranging construction access, establishing temporary utilities, and preparing for excavation.
You’re now ready to build.
How Long Does Pre-Construction Take?
For a typical custom home in Abbotsford:
- Consultation through to design completion: 6–10 weeks
- Engineering and permit submission preparation: 4–6 weeks
- City of Abbotsford permit review: 6–12 weeks
- Budget finalization, contract, and trade booking: 2–4 weeks
Total: 4 to 8 months from your first consultation to the day construction begins. Some projects move faster; projects with complex design elements or non-standard zoning can take longer.
The pre-construction phase is not dead time; it’s the foundation your project is built on. Families who understand this, and who engage fully in the process, consistently have better outcomes than those who rush to get shovels in the ground.
Work With a Builder Who Manages the Whole Process
The pre-construction phase involves coordination between the client, architect, structural engineer, the City of Abbotsford, and multiple trade contractors. A builder who manages this process from the start, rather than handing it off or expecting you to coordinate, is an enormous advantage.
Robson Home Builders handles the entire pre-construction process for every project. Nick Robson is personally involved from the initial consultation through to permit approval and construction commencement, so you always have one point of contact who knows your project inside and out.
Starting to think about a custom home build? Talk to Nick at Robson Home Builders; he’ll walk you through the full process at a free initial consultation. Call 778.823.2376 or visit robsonhomebuilders.com
